Appendix D - Flowcharts

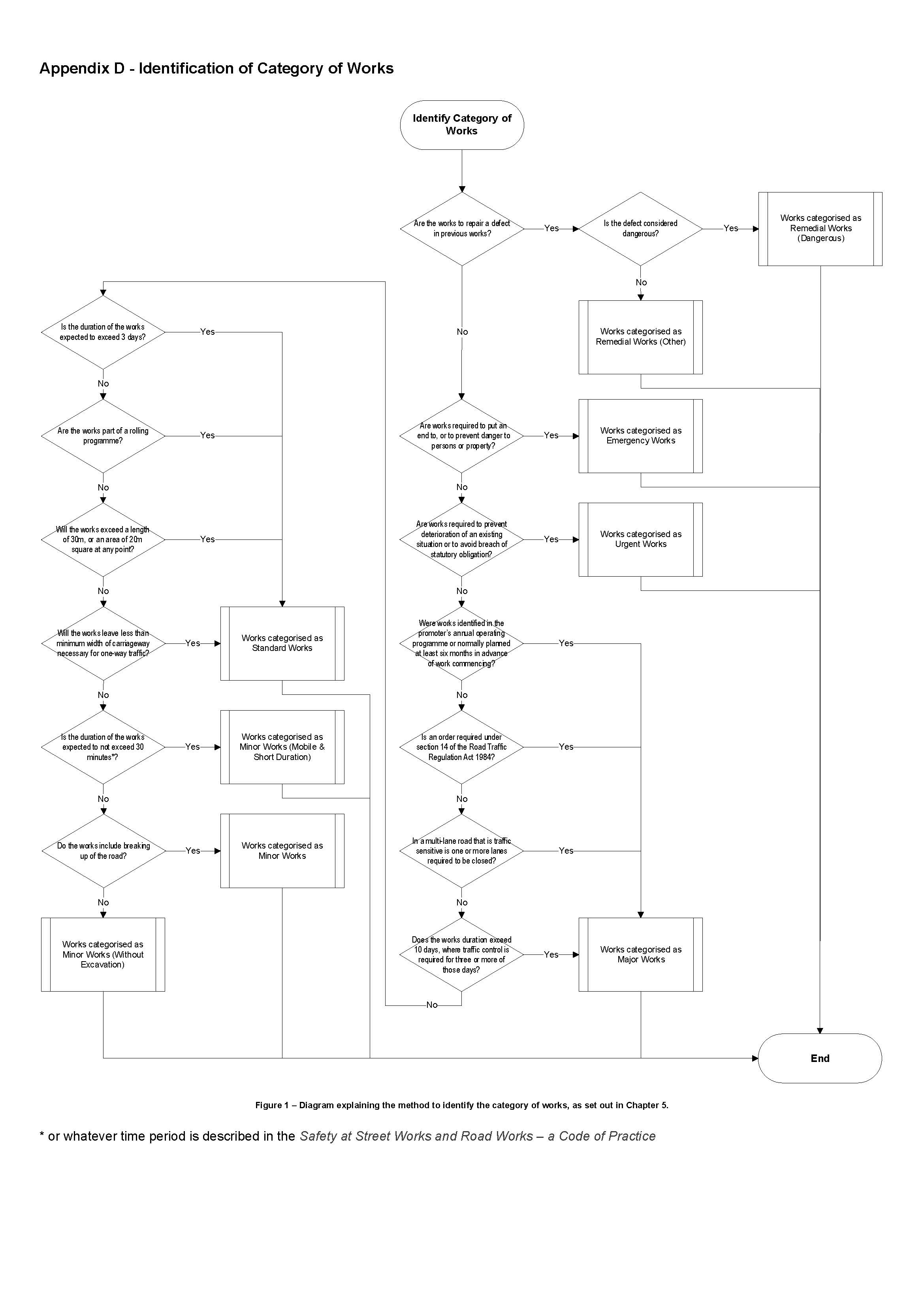

Identification of Category of Works
*or whatever time period is described in the Safety at Street Works and Road Works – a Code of Practice.

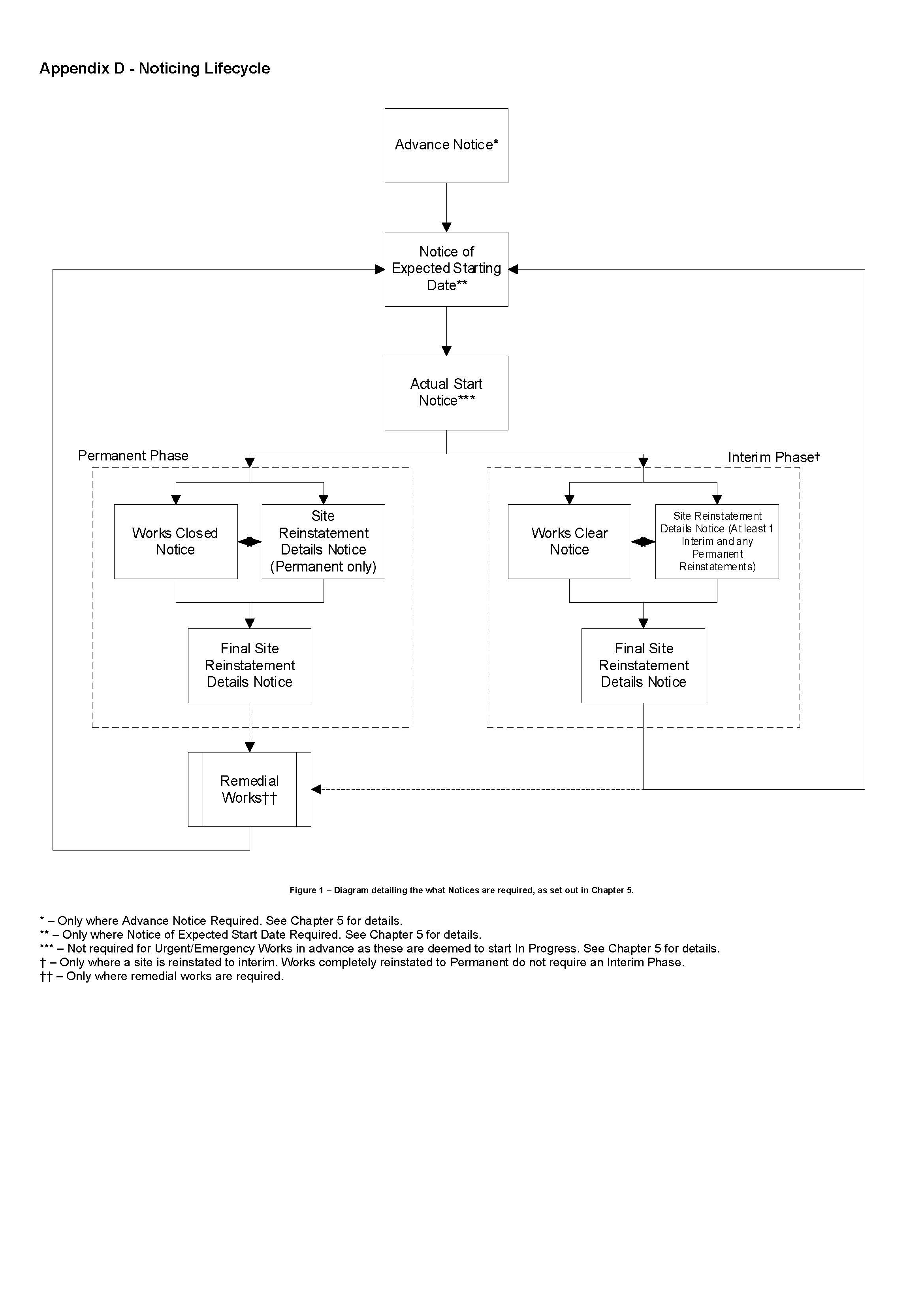

Noticing Lifecycle
* – Only where Advance Notice Required. See Chapter 5 for details.
** – Only where Notice of Expected Start Date Required. See Chapter 5 for details.
*** – Not required for Urgent/Emergency Works in advance as these are deemed to start In Progress. See Chapter 5 for details.
† – Only where a site is reinstated to interim. Works completely reinstated to Permanent do not require an Interim Phase.
†† – Only where remedial works are required.
