Annex C - BEAR Scotland Wider A83 Presentation Slides

Slide 1 - Meeting details

Slide 1 Meeting Details

A83 Taskforce

Part 2: Wider A83

Slide 2 - Works Undertaken Since Previous Meeting

Slide 2 - Work undetaken since last meeting

A83 Taskforce

Works Undertaken Since Previous Meeting

  • Total A83 investment between October and January = £3.4M

Road Resurfacing

·       A83 Kennacraig Phase 1

·       A83 Arrochar to River Loin

·       A83 North of Bellochantuy

·       A83 Tangy

·       A83 Leamnamuic

Road Patching

·       A83 West Loch Shores

·       A83 Corranbuie

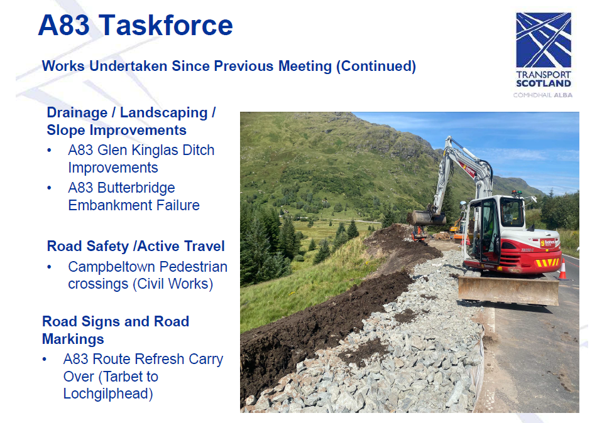

Slide 3 - Works Undertaken Since Previous Meeting

Slide 3 - Works Undertaken Since Previous Meeting

A83 Taskforce

Works Undertaken Since Previous Meeting (continued)

Drainage / Landscaping / Slope Improvements

  • A83 Glen Kinglas Ditch Improvements
  • A83 Butterbridge Embankment Failure

Road Safety / Active Travel

·       Campbelltown Pedestrian Crossings (Civils Works)

Road Signs and Road Markings

·       A83 Route Refresh Carry Over (Tarbet to Lochgilphead)

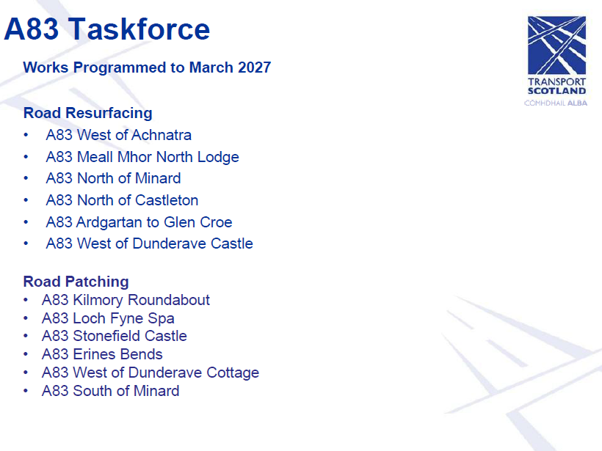

Slide 4 - Works Programmed for March 2027

Slide 4 - Works Programmed to March 2027

A83 Taskforce

Works Programmed to March 2027

Road Resurfacing:

·     A83 West if Achnatra

·       A83 Meall Mhor North Lodge

·       A83 North of Minard

·       A83 North of Castleton

·       A83 Ardgartan to Glen Croe

·       A83 West of Dunderave Castle

Road Patching

·       A83 Kilmory Roundabout

·       A83 Loch Fyne Spa

·       A83 Stonefield Castle

·       A83 Erines Bends

·       A83 West of Dunderave Cottage

·       A83 South of Minard

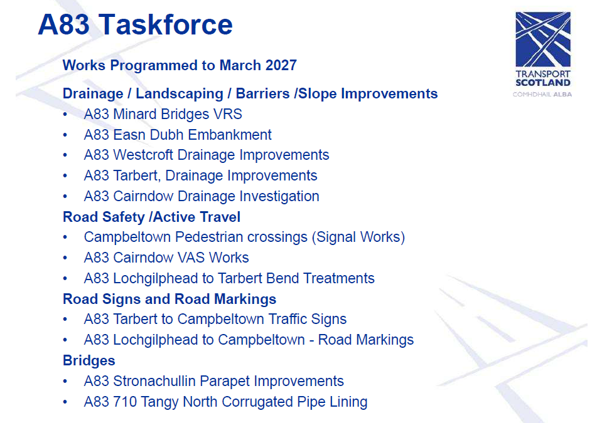

Slide 5 - Works Programmed for March 2027

Slide 5 - Works Programmed to March 2027

A83 Taskforce

Works Programmed to March 2027

Drainage / Landscaping / Barriers / Slope Improvements

·       A83 Minard Bridges VRS

·       A83 Easn Dubh Embankment

·       A83 Westcroft Drainage Improvements

·       A83 Campbeltown Road, Tarbert, Drainage

·       A83 Cairndow Drainage Investigation

Road Safety / Active Travel

·       Campbeltown Pedestrian crossings (Signal Works)

·       A83 Cairndow VAS Works

·       A83 Lochgilphead to Tarbert Bend Treatments

Road Signs and Road Markings

·       A83 Tarbert to Campbeltown Traffic Signs

·       A83 Lochgilphead to Campbeltown – Road Markings

Bridges

·       A83 Stronachillin Parapet Improvements

·       A83 710 Tangy North Corrugated Pipe Lining

Slide 6 - Thank you and any questions

Slide 6 - Thank you and any questions

A83 Taskforce

Thank You & Any Questions
